Tenth Street Improvements
Project overview

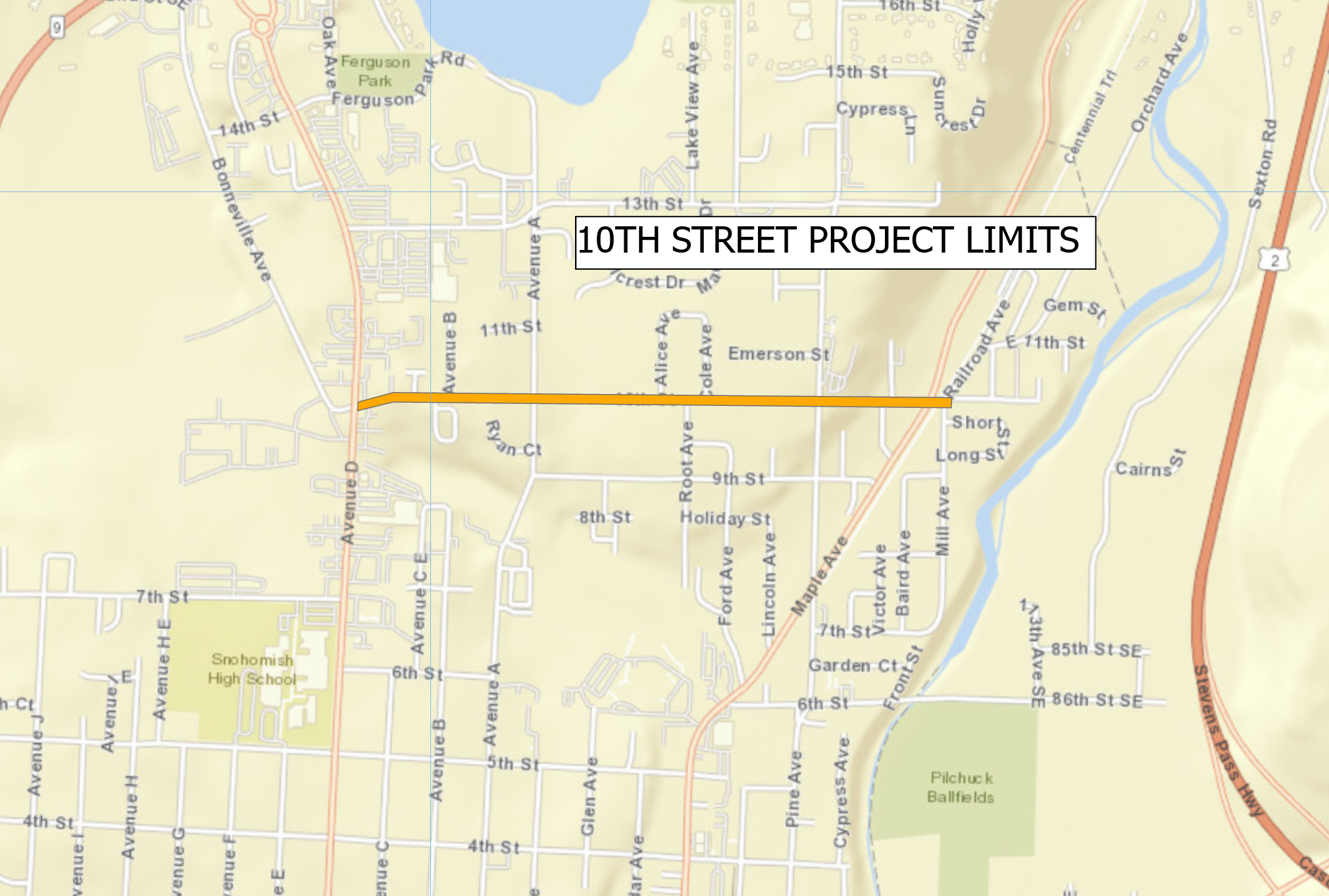

The Tenth Street project will replace old, inadequate public utility infrastructure with repair and resurfacing of the road. The project will take place entirely within the City right-of-way of Tenth Street from Avenue D to Maple Avenue. Additional work within Avenue A right-of-way is proposed from Tenth Street to 11th Street.
| Timeline | Summer 2025 |
| Project Status | Pre-construction |
| Funding | Transportation Improvement Board (TIB) grant funding is being utilized for this project. |
What to expect

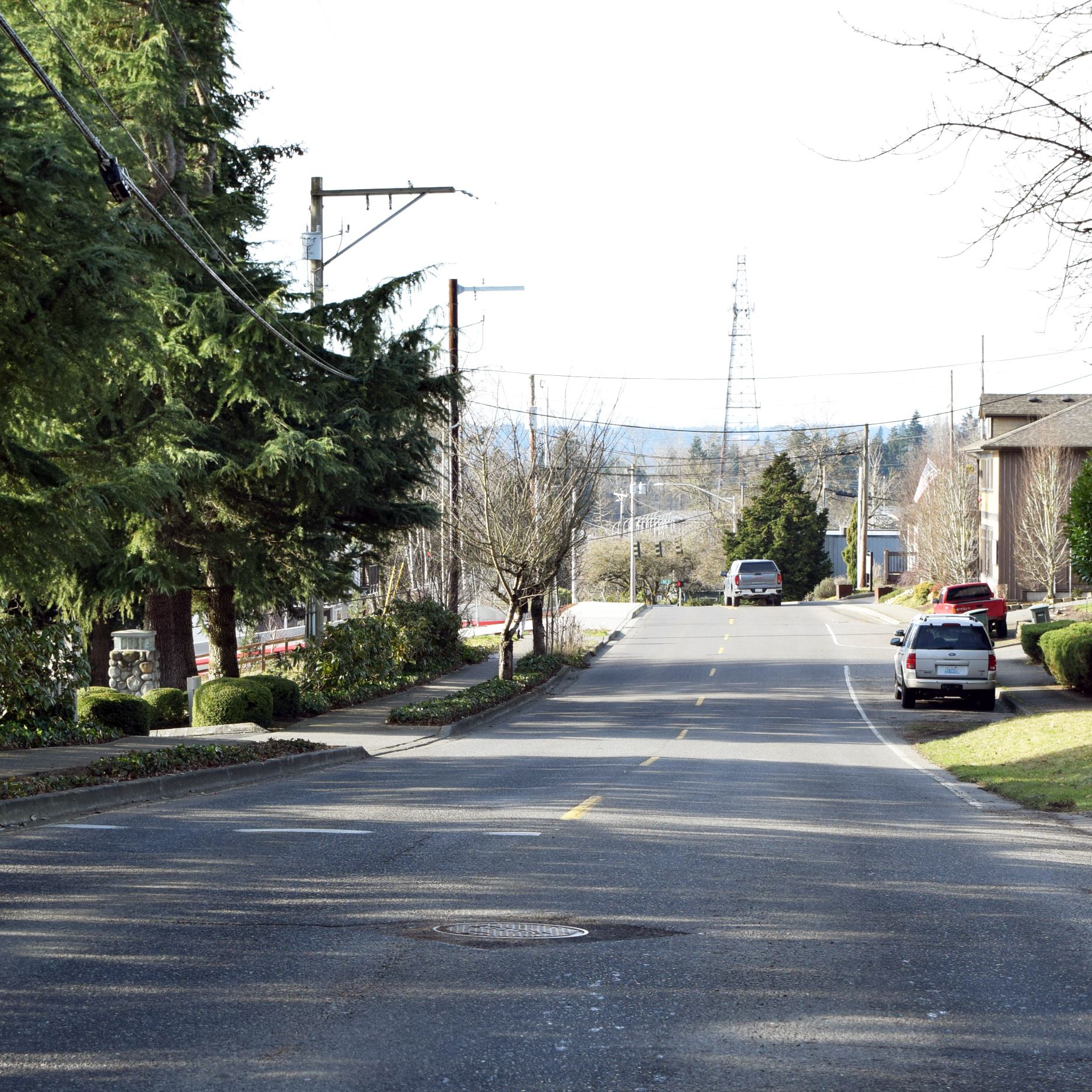

The Tenth Street Overlay project is set to grind and overlay the project area following installation of new water, sewer, and stormwater utilities, as well as full depth repair of failing road sections. All existing utility services will be reconnected to the new installed infrastructure. Expect lane closures and traffic revisions on Tenth Street and Ave D during construction. Some customers may experience brief interruptions to utility services.
This project entails:
- Replacing the existing water main on Tenth Street. New services to connect to existing meters.
- Replacing the existing sanitary sewer in Tenth Street and in Avenue A. New side sewers will connect to existing customer side sewers at the property line.
- Drainage improvements, such as extra catch basins, will be added necessary to improve drainage.
- New ADA ramps at road intersections if existing ramps are out of compliance, or none currently exist.
- Final restoration for 10th Street and Avenue A will involve a complete grind and overlay.
The Contractors information will be posted once awarded the project. Residents and businesses may coordinate directly with the contractor and independent of the City for private construction opportunities subject to permit requirements. Door hangers and flyers will be delivered prior to start of construction with City and Contractor contact information.
| May 2025 | Project advertised for competitive bidding |
| July 2025 | Contractor selected |
| August 2025 | Construction begins |
| December 2025 | Construction scheduled for completion |
| 10th Street (Avenue D - Maple Avenue) Improvement Estimate | $6.48 million |
1. Will my driveway access be impacted?
Driveway access may be restricted for a short time, but the Contractor will make efforts to allow free ingress and egress with driveways.
2. Will there be any road or intersection closures?
Currently no full road or intersection closures are anticipated, however this may change during construction with adequate notice provided. There will be traffic control for any lane closures or work within vehicle travel lanes and Variable Message Signs (VMS) will be set out to deliver traffic control notices.
3. Will there be any work on my property?
The only portion of work that will require coordination with property owners will be reconnecting the water and sewer services to each property. Three (3) days' notice will be provided prior to any work on active water and sewer services.
Brennan Collins
City of Snohomish Project Engineer
425-903-1812
Email Brennan
